Angra 3 may have operation delayed due to contract reviews

Plant operation beginning in May 2018.

Valor Econômico
22/04/2014 19:27

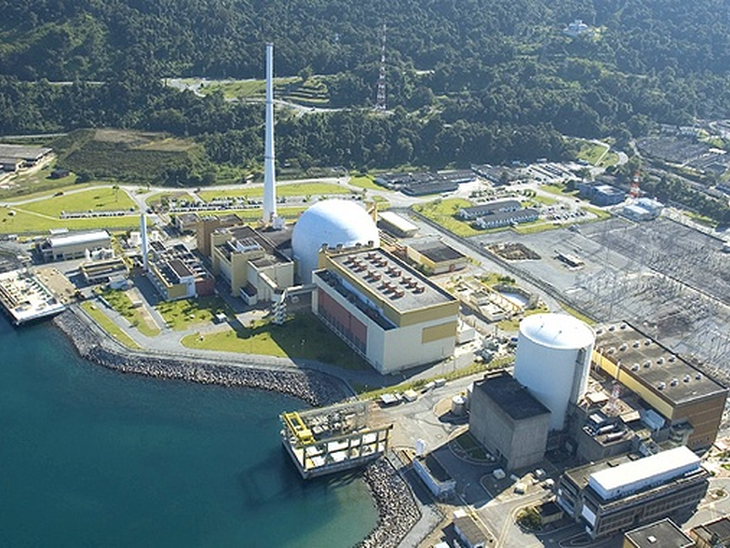

Angra 3 may have operation delayed due to contract reviews Imagem: Divulgation Eletrobras Visualizações: 739 (0) (0) (0) (0)



Angra 3 may have operation delayed due to contract reviews
More than two months after the result of the billion-reais bidding for the electromechanical assembly services of nuclear plant Angra 3, Eletronuclear, owner of the project, has not yet signed the contract with the winning consortia, which can affect the date for the beginning of the plant operation, in May 2018.
The delay is attributed to a decision of Eletrobras generation director, Valter Cardeal, who wanted to review the consortia’s proposal to try to reduce the cost of services. Highly regarded by President Dilma Rousseff, Mr. Cardeal has previously adopted a similar attitude with respect to contracts of Belo Monte Dam.

More than two months after the result of the billion-reais bidding for the electromechanical assembly services of nuclear plant Angra 3, Eletronuclear, owner of the project, has not yet signed the contract with the winning consortia, which can affect the date for the beginning of the plant operation, in May 2018.



The delay is attributed to a decision of Eletrobras generation director, Valter Cardeal, who wanted to review the consortia’s proposal to try to reduce the cost of services. Highly regarded by President Dilma Rousseff, Mr. Cardeal has previously adopted a similar attitude with respect to contracts of Belo Monte Dam.

Most Read Today
see see
Partnership
Halliburton and Shape Digital establish strategic collab...
06/05/26
ROG.e
ROG.e 2026 will bring together CEOs from TotalEnergies, ...
06/05/26
International
At OTC Houston 2026, Firjan SENAI SESI expands its reach...
06/05/26
International
At OTC Houston 2026, Firjan SENAI holds international ed...
04/05/26
Recognition
BRAVA Energia receives top global industry award for Atl...
04/05/26
International
Brazil reaffirms technological leadership at OTC Houston...
04/05/26
Pre-Salt
PPSA closes 2025 with a net profit of R$ 30.1 million
04/05/26
Results
With 5.531 million boe/d, Brazil continues with record o...
04/05/26
International
Brazil reaffirms technological leadership at OTC Houston...
02/05/26
Environment
Brazil appears among world's largest methane emitters in...
30/04/26
PPSA
Federal Government receives R$ 917.32 million from Tupi ...
07/04/26
Study
Brazil increases dependence on thermal power, but lack o...
07/04/26
Permanent Offer
Permanent Production Sharing Offer (OPP): ANP publishes ...
07/04/26
Taxation
Infis Consultoria promotes the 4th Oil & Gas Taxation Se...
07/04/26
Green Hydrogen
Study at RCGI maps regions with the greatest potential f...
07/04/26
iBEM26
Goldwind advances in Bahia with factory in Camaçari and ...
27/03/26
iBEM26
Bahia showcases its bioenergy potential and reinforces i...
27/03/26
iBEM26
ESG practices in the renewable energy sector are highlig...
26/03/26
iBEM26
ABPIP highlights the role of independent producers in en...
26/03/26
iBEM26
Jerônimo Rodrigues highlights Bahia’s potential in the e...
26/03/26
Campos Basin
New oil discovery in the pre-salt of the Campos Basin
26/03/26
VEJA MAIS
Newsletter TN

Contact us

We use cookies to ensure you have the best experience on our website. If you continue to use this site, we will assume that you agree with our Privacy Policy, terms of use and cookies.
